I want to share how I manage multiple library/gem/package updates simultaneously while doing big upgrades. But before we start, it’s important to know why.

Significant upgrades require a more considerable change of files. The number of files you need to change can get out of hand. You may have to replace some code due to the deprecations, or you may have to deploy in multiple stages to avoid breaking the production.

This is why I strive to have more minor changes that can help reduce the final changes. In the end, the last Pull Request (PR) will only have small changes that would help your colleagues to review them safely. Yeah, no one is going to review 50+ changed files.

It’s common for me to have more than 30 PR opened (not at the same time) for one upgrade project. It’s not weird to have 10+ PR(s) opened and waiting for approval or deployment. So, it can be very confusing to maintain all those PR(s) and branches.

It’s not just about having small changes. It’s also about getting into the future, where you are in a state where you have everything merged so that you can work on the future upgrade simultaneously.

In my case, I was working on upgrading v5.2.7 -> v5.2.8 -> v6.1.7 -> v7.0.4 (I’m also upgrading Ruby at the same time, but I won’t go into that to simplify the explanation). The good thing is that I don’t have to wait for everything to be ready before even working on the next upgrade. When I was working on v5.2.8, I have already started to work on v7.0.4 at the same time while waiting for code review and deployments. To me, that’s a BIG ADVANTAGE.

Let’s talk about how I’m doing it. Pretty sure someone else has done this before. It doesn’t require tools (you can create a script if you want to); you need some basic git commands and small notes. It’s hard to explain this without a visualization, so I’ve created one. You guys can see it in the attachment.

diagram

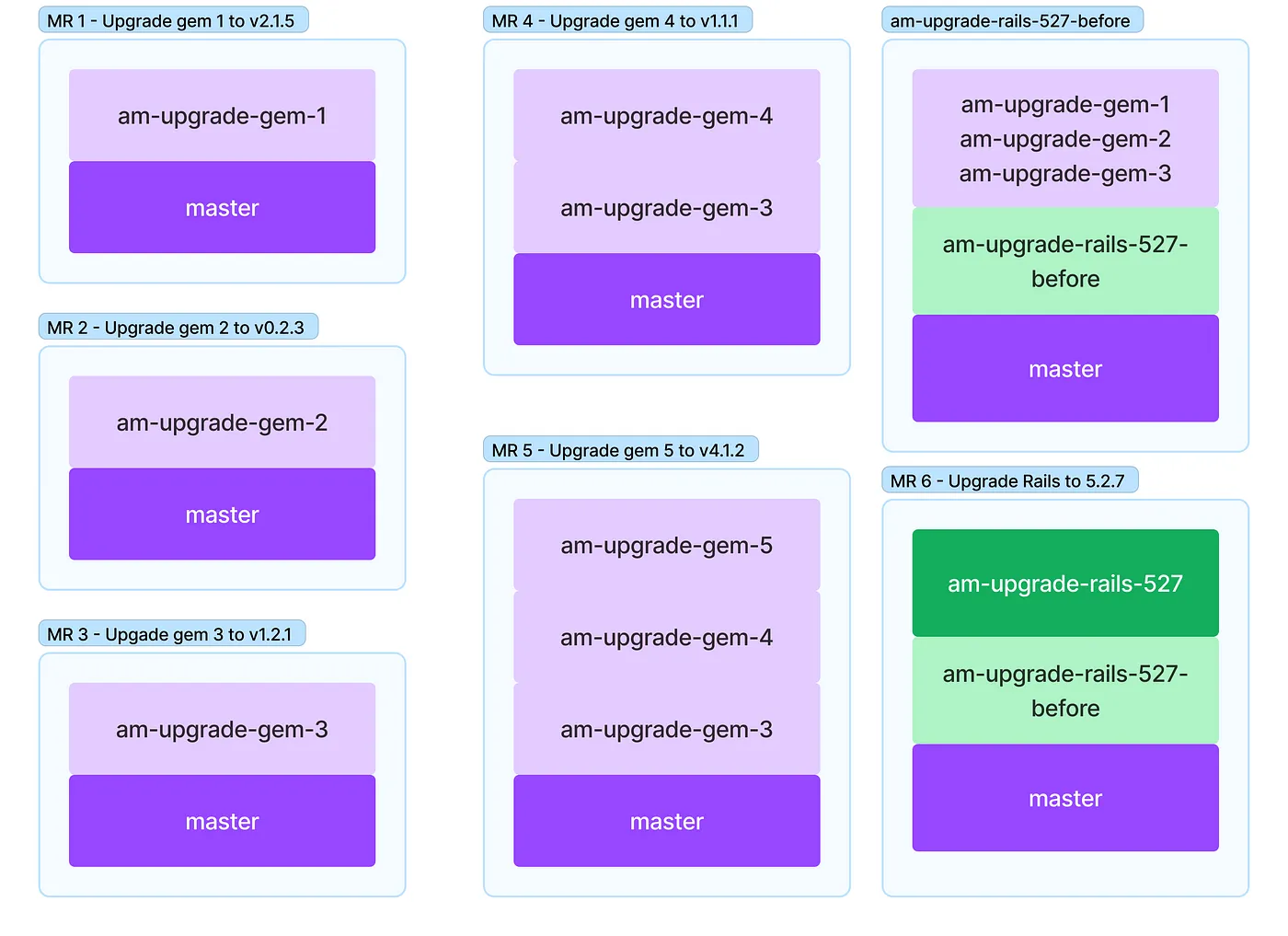

  1. Every PR must be based on the master (master <- pkg-upgrade-1 )

This means you can ensure you won’t break production with this particular change and always rebase from the master whenever needed. If things went wrong when you deployed, you would immediately know the problem compared to having multiple upgrades in one PR. If you have one PR with various upgrades, you’d have to hunt down the part that is causing the problem.

  1. If the change requires another change, use a different base (master <- pkg-upgrade-1 <- pkg-upgrade-2)

The world is always complex, and there’s always a chance that you’d have to depend on a different package before you can work on another upgrade. You can wait for the changes to be deployed, but why should you?

  1. Use a ‘before’ branch before the big upgrade (master <- before-big-upgrade (upgrade1, upgrade2, ..) <- the-big-upgrade)

The big upgrades usually require multiple changes. We can’t use 2nd technique here as that is only suitable for one or two upgrades. We handle this by creating a branch that will combine every small changes that haven’t been merged to the master.

That ‘before’ branch will be used as the base for the big/last upgrade PR. This is HOW WE TRAVEL INTO THE FUTURE. You can even see if your final changes here. The final branch/PR should pass your CI and work locally/staging. If you found any problem, then you can always create small branch to fix it before we merge the final branch.

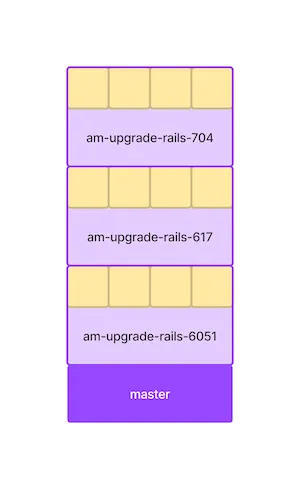

  1. Use the combination of those techniques to work on another major upgrade

We can combine them, and the result would look like this: master <- major-upgrade-1 <- major-upgrade-2 <- major-upgrade-3.

It may look simple, but ‘major-upgrade-1’ PR combines techniques from 1 to 3. It’s a bit hard to wrap your mind when you read it for the first time, but you can look at the image for that. Hopefully, it will help.

diagram

What kind of git command that I need to use?

diagram

Is this the best way to do this? It helped me keep working without being blocked by pending PR or deployments. Remember, I don’t deploy immediately to ensure I can monitor for regressions. Usually, I’d put some gaps between deployments.

Thanks for reading if you managed to get this far. I’m planning to do a presentation on this in the future, and writing this will help me explain the method better.
